Please enter keywords to search

Global |EN

Choose your country & Language

Asia Pacific

Australia & New Zealand
India
Indonesia
Malaysia
Philippines
Singapore

Middle East & Africa

Kenya
Saudi Arabia
South Africa
United Arab Emirates

Europe

France
Kazakhstan
Netherlands
Spain
Italy
Turkey
United Kingdom
Poland

Latin America

Brazil
Colombia
Ecuador
Peru

North America

Canada
Mexico
United States

Choose your country & Language

Australia & New Zealand
India
Indonesia
Malaysia
Philippines
Singapore
Kenya
Saudi Arabia
South Africa
United Arab Emirates
France
Kazakhstan
Netherlands
Spain
Italy
Turkey
United Kingdom
Poland
Brazil
Colombia
Ecuador
Peru
Canada
Mexico
United States

Please enter keywords to search

Your search term contains restricted words. Please use different keywords.

CHINT Delivers First Smart Substation EPC Project for NGCP to Advance Smarter Grid in the Philippines

SEP 1, 2026

A smarter grid starts with smarter substations. Amid rising electricity demand and ongoing grid modernization across the Philippines, the National Grid Corporation of the Philippines (NGCP) is advancing its Visayas Substation Upgrading Project to strengthen transmission resilience and operational efficiency. As a key initiative under this program, CHINT is delivering the Panitan 138kV Substation as an integrated EPC turnkey contractor, marking CHINT’s first smart substation project with the Philippines’ national transmission grid operator.

The project transforms the substation’s existing air-insulated switchgear (AIS) infrastructure into an intelligent gas-insulated switchgear (GIS)-based facility, upgrading a core transmission node in Capiz, Visayas to support the region’s long-term power development.

CHINT recognized as China's Top Employers 2025
CHINT recognized as China's Top Employers 2025
CHINT recognized as China's Top Employers 2025

Full-Scope EPC Turnkey Delivery

CHINT provides a comprehensive end-to-end EPC solution covering the full project lifecycle, including engineering, equipment supply, civil and structural works, installation, commissioning, communication systems, secondary protection and control, mechanical systems, and full HSE management.

Key equipment and systems supplied by CHINT include 138kV GIS, 69kV GIS, disconnect and earthing switches, shunt reactors, CT/VT, surge arresters, AC/DC auxiliary power supply systems, as well as intelligent protection, control and communication platforms.

The upgrade is implemented in two sequenced phases to minimize operational disruption:

  • Phase I: Focuses on replacement of the 138/69kV 100MVA power transformer and supporting primary equipment upgrades, with existing secondary equipment retained and cables re-terminated to reduce reconstruction costs and outage impact.
  • Phase II: Delivers full AIS-to-GIS reconstruction, a new 5-storey GIS building, 12 new 138kV and 69kV GIS bays, and station-wide deployment of intelligent secondary systems.

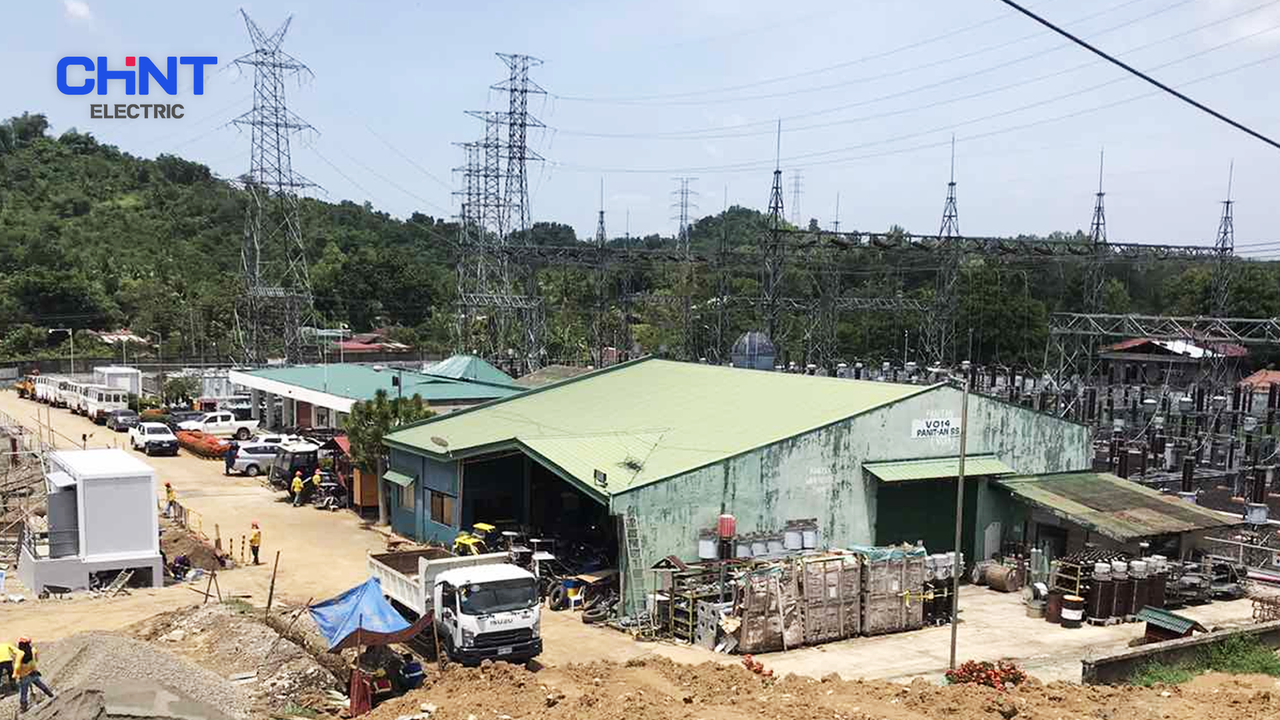

Project team standing in front of a high-voltage substation during nighttime commissioning work
Project team standing in front of a high-voltage substation during nighttime commissioning work
substation-project-team-at-night
High-voltage substation with transformer equipment and electrical switchgear at night

High-voltage substation with transformer equipment and electrical switchgear at night
high-voltage-substation-transformer-equipment

Navigating Brownfield Upgrade Challenges

As a brownfield upgrade executed entirely within an active operating substation, the project demands rigorous planning and precision execution to maintain grid reliability throughout construction. CHINT addresses core challenges through targeted engineering and on-site management:

  • Meticulous outage scheduling and temporary power arrangements to enable safe construction on a live substation
  • Seamless AIS-to-GIS transition within constrained site space, coordinating large-scale demolition, civil works and GIS equipment integration
  • Phased smart system migration from conventional control architectures to intelligent protection, SCADA and communication platforms, with coordinated protection settings across new and legacy equipment
  • Coordinated grid connection modifications and line-by-line equipment upgrades to preserve transmission stability and avoid service disruption

Project team standing in front of a high-voltage substation during nighttime commissioning work
Project team standing in front of a high-voltage substation during nighttime commissioning work
substation-project-team-at-night
High-voltage substation with transformer equipment and electrical switchgear at night

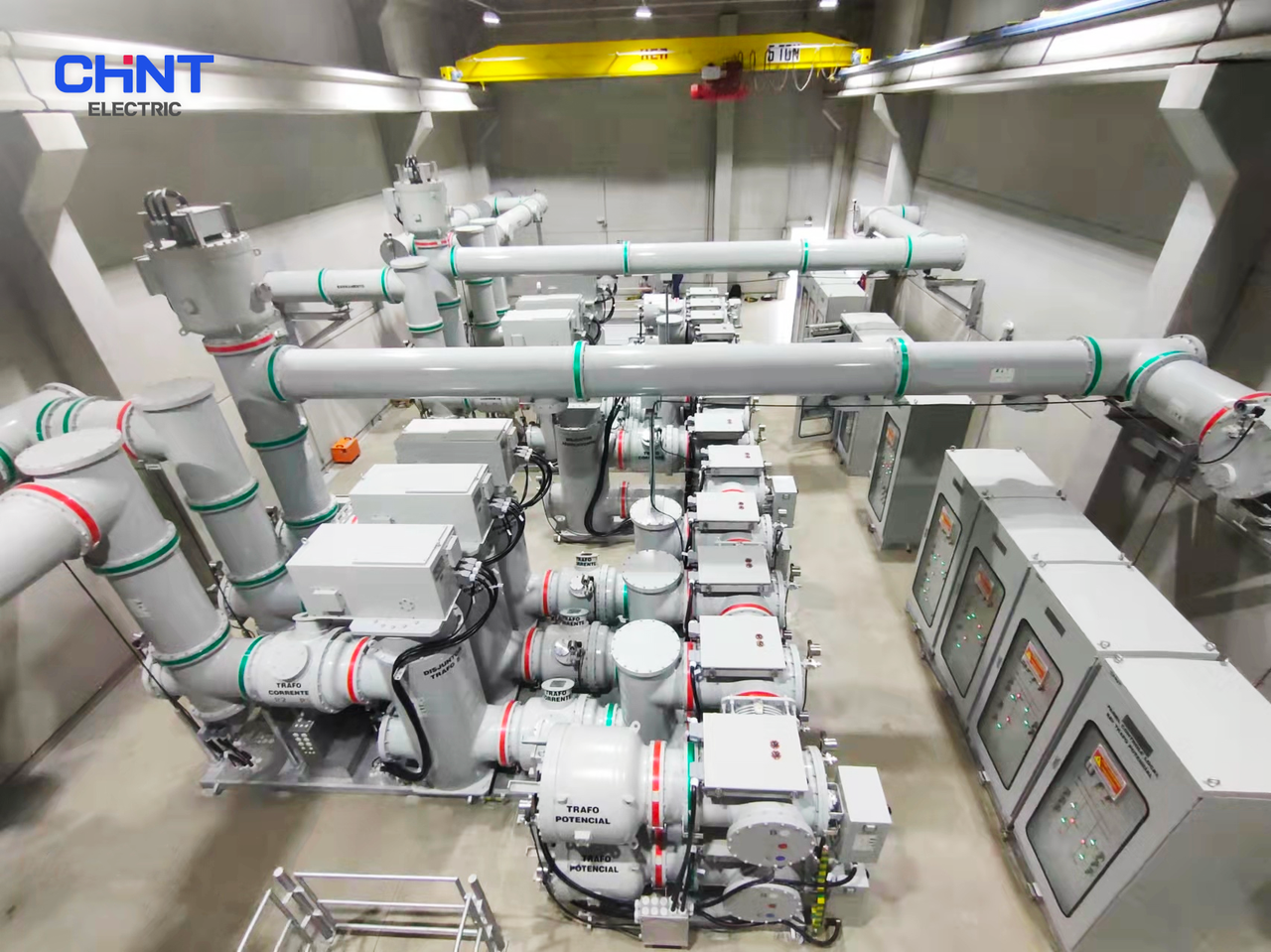

High-voltage substation with transformer equipment and electrical switchgear at night
high-voltage-substation-transformer-equipment

Driving Value for Philippine Grid Modernization

Through integrated EPC delivery and advanced GIS-based smart substation solutions, CHINT is helping NGCP unlock measurable benefits for the Visayas transmission network:

  • Enhanced grid reliability: Upgraded critical substation infrastructure significantly improves system stability and operational reliability for the region
  • Smart substation transformation: The upgrade enables the shift from traditional substation management to an intelligent, digitalized protection, control and monitoring platform
  • Product & technology breakthrough: The project marks the first application of CHINT’s 138kV and 69kV GIS equipment for NGCP, validating CHINT’s high-voltage product capabilities in the Philippine market
  • Streamlined turnkey delivery: CHINT’s single-source EPC model reduces interface risks, improves delivery efficiency and ensures end-to-end project accountability
  • Strengthened strategic partnership: As CHINT’s first smart substation EPC project for NGCP, the initiative deepens bilateral cooperation and lays the groundwork for future collaboration on Philippine grid modernization

Moving forward, CHINT will continue to leverage its full industry chain advantages and smart grid expertise to support the development of smarter, more resilient power infrastructure across the Philippines, and contribute to the country’s sustainable energy transition.

The Latest
OCTOBER 10, 2026 CHINT 2026 September Product Express

Welcome to CHINT Product Express! Here we're sharing our featured products designed for reliable performance and global applications. Let’s explore CHINT’s innovative products together.

OCTOBER 10, 2026 CHINT 2026 August Product Express

Welcome to CHINT Product Express! Here we're sharing our featured products designed for reliable performance and global applications. Let’s explore CHINT’s innovative products together.

OCTOBER 8, 2026 Powering Speed and Scale: CHINT Supports Southeast Asia’s Largest Sorting Center in Vietnam

As Southeast Asia’s e-commerce sector accelerates, logistics infrastructure is being pushed to new limits—demanding not only speed and scale, but also unwavering reliability behind the scenes.

SEPTEMBER 28, 2026 CHINT Customer Service Completes Coverage Across Five Continental Regions, Supporting International Business Growth

CHINT expands its global customer service network across five major regions, offering multilingual, responsive pre-sales and after-sales support worldwide.

SEPTEMBER 8, 2026 CHINT Semi-Annual Report of 2026

Discover CHINT’s 2026 Semi-Annual Report highlighting strong financial growth, global expansion, smart electrical innovation, and green energy solutions driving a sustainable future.

SEPTEMBER 1, 2026 CHINT Delivers First Smart Substation EPC Project for NGCP to Advance Smarter Grid in the Philippines

A smarter grid starts with smarter substations. Amid rising electricity demand and ongoing grid modernization across the Philippines, the National Grid Corporation of the Philippines (NGCP) is advancing its Visayas Substation Upgrading Project to strengthen transmission resilience and operational efficiency.

SEPTEMBER 1, 2026 CHINT Electric Awarded EcoVadis Gold Medal, Ranking in Top 3% of Global Enterprises

CHINT Electric Co., Ltd. has earned the EcoVadis Gold Medal in its FY2025 sustainability assessment, scoring 84 points overall — a 5-point year-on-year improvement — and advancing its global percentile from the top 4% to the top 3% of all rated enterprises worldwide.

SEPTEMBER 1, 2026 CHINT Showcased Advanced Power Solutions at CIGRE 2026

As Europe's power grids evolve to accommodate renewable energy, electrification and rapidly growing electricity demand, CHINT showcased its latest power solutions at CIGRE 2026, highlighting how advanced technologies can help utilities and energy customers modernize their grids, improve reliability and accelerate the energy transition.

AUGUST 10, 2026 How CHINT T&D is solving Europe’s infrastructure supply crisis

Interview with Dr. Naihu Li, Vice-President of CHINT T&D and Head of the CHINT Group R&D Institute

AUGUST 7, 2026 CHINT Electric Successfully Completes Full Test Program for Its First 1000kV/1000MVA UHV AC Transformer

As China continues to advance its large-scale west-to-east and north-to-south power transmission strategy, Ultra-High Voltage (UHV) transmission has become the backbone of long-distance electricity delivery. At the heart of every UHV transmission project is the transformer—a critical piece of equipment that determines system efficiency, reliability, and operational safety.
